A lot of Seattle-area homeowners start in the same place. They have a lot, or they're close to buying one. They have sketches, Pinterest boards, a builder conversation on the calendar, and a rough sense of what they want their home to feel like. Then the financing questions hit all at once. How does the bank release money? What happens if permits drag? When does the builder get paid? What if the site needs more work than expected?
That's where many projects either get organized or get shaky.
A residential construction loan isn't just a way to borrow money. It's the framework that controls how your project moves from land, plans, and permits into excavation, framing, inspections, and final occupancy. In practice, the loan structure affects your schedule, your change-order flexibility, and how much stress you feel when the inevitable surprises show up.
From Dream to Foundation Why Your Loan Strategy Matters
A family in the Seattle-Tacoma area might begin with a simple goal: build a custom home that finally fits how they live. Maybe they've outgrown their current place. Maybe they found a lot with a view. Maybe they want a main-floor primary suite, better natural light, and a kitchen that doesn't force traffic jams every evening.
Then reality steps in. The lot has questions. Utilities need coordination. The jurisdiction wants permit revisions. The lender needs a budget that matches the plans. The builder needs a draw schedule that won't choke the job halfway through framing.
That's why loan strategy matters early. If you treat financing as a last-minute approval step, you usually end up redesigning the project around lender constraints. If you treat financing as part of project management, you can line up scope, permitting, builder coordination, and cash flow before the first machine arrives on site.
The loan is part of the build plan
In the U.S., the scale of homebuilding helps explain why this matters. The Census Bureau reported 1,465,000 privately owned housing starts at a seasonally adjusted annual rate in April 2026, including 903,000 single-family housing completions and 872,000 single-family authorizations, showing how much residential activity depends on staged funding rather than one lump-sum payment (Census new residential construction data).
Those staged funds shape real decisions:
- Permit timing affects financing use: If permitting stalls, the clock on your broader pre-construction work doesn't stop.
- Builder sequencing affects loan efficiency: If the schedule is out of order, inspections and draw requests can bottleneck.
- Site readiness affects stress: A lot that looks straightforward on paper can become expensive before vertical construction even starts.
Good projects don't just have enough money. They have money arriving at the right time, with paperwork and scheduling tight enough to keep the site moving.
If you're still at the property-selection stage, it helps to understand the land buying process in Washington before you commit to plans built on assumptions. And if you're comparing how organizations handle staged funding controls, even outside residential work, this piece on managing construction loans for nonprofits is useful because it highlights the operational side of draw management, documentation, and oversight.
Decoding Residential Construction Loan Types
A standard mortgage pays for a finished house. A construction loan pays for a house that does not exist yet.
That's the simplest way to think about it. A mortgage is usually a lump-sum loan secured by a completed property. A construction loan works more like controlled funding for a moving target. Money is released in stages as the house takes shape.
How these loans work in plain language
Residential construction loans are typically structured as short-term, interest-only credit with money released through a draw schedule tied to milestones. Before each draw, an inspection is commonly required to verify progress, and the borrower pays interest only on the amount already drawn (how construction loans work).
That structure is practical for lenders, but it also changes how owners should think. You're not just choosing a loan product. You're choosing how much administrative friction, closing complexity, and rate exposure you're willing to manage.
Comparison of Construction Loan Types
| Loan Type | Best For | Closings | Rate Risk |
|---|---|---|---|
| Construction-to-permanent | Owners who want a simpler path from build phase to long-term mortgage | One | Lower administrative uncertainty because the end financing is built into the structure |
| Construction-only | Owners who want flexibility to arrange permanent financing later | Two | More exposure because the permanent loan is handled after construction |
| Renovation loan | Owners improving an existing home rather than building from the ground up | Usually structured around one primary financing path, depending on lender and project | Depends on how the lender structures the renovation and end financing |
Construction-to-permanent
This is the cleanest fit for many owner-build projects. You close once, build under that loan structure, and then move into the permanent mortgage phase at completion if all requirements are met.
What works well about it is predictability. There's less paperwork at the end, fewer moving parts during the transition, and less chance that a second closing creates a last-mile problem after the house is done.
What doesn't work as well is reduced flexibility if your long-term financing strategy changes mid-project.
Construction-only
This option separates the build financing from the future mortgage. Some borrowers prefer that because it gives them room to shop for the permanent loan later.
That flexibility can be useful. It also creates another underwriting event at the end of construction. If the market shifts, the appraisal comes in differently than expected, or your financial picture changes, the payoff and refinance stage can get tense.
If you don't want two financing events, don't choose a structure that requires two financing events and hope it feels simple later.
Renovation loans
These fit major remodels, additions, or rebuild-style projects where the existing home remains part of the financing story. They can make sense in Seattle neighborhoods where moving isn't attractive, but the house needs major functional change.
The challenge is scope control. Renovation budgets can unravel faster than new-build budgets if demolition reveals hidden conditions or owners keep changing finish selections once walls are open.
How to Qualify and Apply for Your Construction Loan
A lot of borrowers hit trouble before the first shovel goes in the ground. They have the income, decent credit, and a clear idea of the house they want, but the loan file still stalls because the lender is underwriting a build, not just a borrower.
In practice, approval rests on three parts lining up at the same time: your finances, your project documents, and your builder's ability to execute the job under lender oversight. If one of those is loose, the file gets slower, more expensive, or denied.
Pillar one, the borrower
Your personal finances still set the baseline. Construction lenders usually want stronger reserves, cleaner debt ratios, and more cash in the deal than a standard purchase loan. The Consumer Financial Protection Bureau's overview of construction and renovation loans explains the basic structure, including the higher risk profile and staged funding that make these loans different from ordinary mortgages.
That higher scrutiny shows up early. Expect the lender to review bank statements, source of funds, tax returns, employment or business income, and whether you can carry interest payments during the build. In the Seattle-Tacoma market, I also tell clients to assume the lender will look hard at liquidity, because permit timing and site work can stretch a project longer than the optimistic schedule in the first draft.
Strong credit helps. It does not fix a weak file.
Pillar two, the project package
Solid planning saves months.
Lenders want a package they can price, review, and monitor without guessing. If your plans are still shifting, your allowances are vague, or your permit path is unclear, the lender sees a moving target. In this market, that matters because sloped sites, drainage requirements, tree rules, utility coordination, and jurisdiction-specific comments can all change the timeline before vertical work starts.
A lender-ready package usually includes:
- Complete plans: The drawings need to match the scope the lender is financing.
- A line-item budget: Site work, utilities, drainage, finishes, and allowances should be specific enough that someone outside the project can follow them.
- A realistic schedule: Not a perfect-case calendar. A schedule that accounts for permit review, inspections, procurement, and likely sequencing.
- A signed construction contract: The lender needs clear responsibility for scope, cost, payment terms, and change orders.
The biggest mistake I see is an owner submitting a budget that looks clean on paper but is thin where real jobs get expensive. Civil work, power upgrades, stormwater requirements, and finish allowances are common problem areas around Seattle and Tacoma. If those numbers are soft, underwriting gets tense fast.
Pillar three, the builder
The builder is part of the credit decision. Lenders often want to see experience, licensing, insurance, a credible contract, and a project plan that matches the scope and budget. Lendsure's summary of ground-up construction loan requirements reflects that reality. The lender is not only asking whether you can repay the loan. It is also asking whether the job is organized well enough to get built.
That is why builder selection affects financing odds. A builder who can hand over a clean scope, realistic allowances, schedule logic, and permit status gives the underwriter something they can approve. A builder who waves at missing details and says they will sort it out later usually creates friction for everyone.
Before you apply, pressure-test the package like a project manager would. Who is building it? What is included? What is excluded? Which jurisdiction is reviewing permits? What long-lead items could hit the schedule? How will changes be handled once the loan closes?
For homeowners who need help getting those pieces organized, residential construction project management support can help turn plans and assumptions into a lender-ready scope, budget, and schedule. Turning Point Ventures, LLC is one local firm that handles planning, permitting coordination, and project management alongside the build. That kind of early coordination often makes the application cleaner and reduces surprises during underwriting.
The Draw Process How Money Flows from Lender to Lumber
A Seattle-area build can be framing-ready on paper and still stall for a week because the draw request is incomplete, the inspection is late, or the lender will not release funds until one missing invoice shows up. Owners are often surprised by that. The loan is approved, the crew is lined up, and yet the site slows down because the cash flow sequence was not managed tightly.
The draw process controls that sequence. Funds are released in stages after work is in place and documented. If the builder, owner, and lender are not working from the same schedule, the project starts burning time while everyone waits for money to catch up.
How a draw usually works on a real job
On most residential projects, the pattern looks like this:
- A defined phase of work is finished such as excavation, foundation, framing, or rough-ins.
- The builder submits a draw request with invoices, photos, lien releases if required, and any lender forms.
- The lender orders or reviews an inspection to confirm the work matches the request.
- Funds are released for that completed portion of the job.
- Subs and suppliers get paid and the next phase can move without payment disputes hanging over it.
That sounds tidy. In practice, the friction shows up between those steps.
If the inspection gets scheduled three days later than expected, the electrician may push your rough-in start. If the draw package shows 90 percent of framing billed but the inspector sees 75 percent complete, the lender may cut or delay the draw. If suppliers are waiting on payment, they can put the account on hold right when windows, trusses, or cabinets need to ship.
The real risk is schedule drift
Construction loans usually carry higher rates than permanent mortgages and require interest payments while the home is being built, as noted earlier. Every extra week under construction has a cost. In the Seattle-Tacoma market, that cost often stacks on top of weather delays, utility coordination, permit corrections, and long lead times for windows, switchgear, or specialty finishes.
That is why I tell owners to treat draws as part of project management, not just banking paperwork. The money flow has to match the build sequence. A lender may be perfectly willing to fund the job, but lenders do not manage your permit responses, inspection timing, trade sequencing, or selection deadlines.

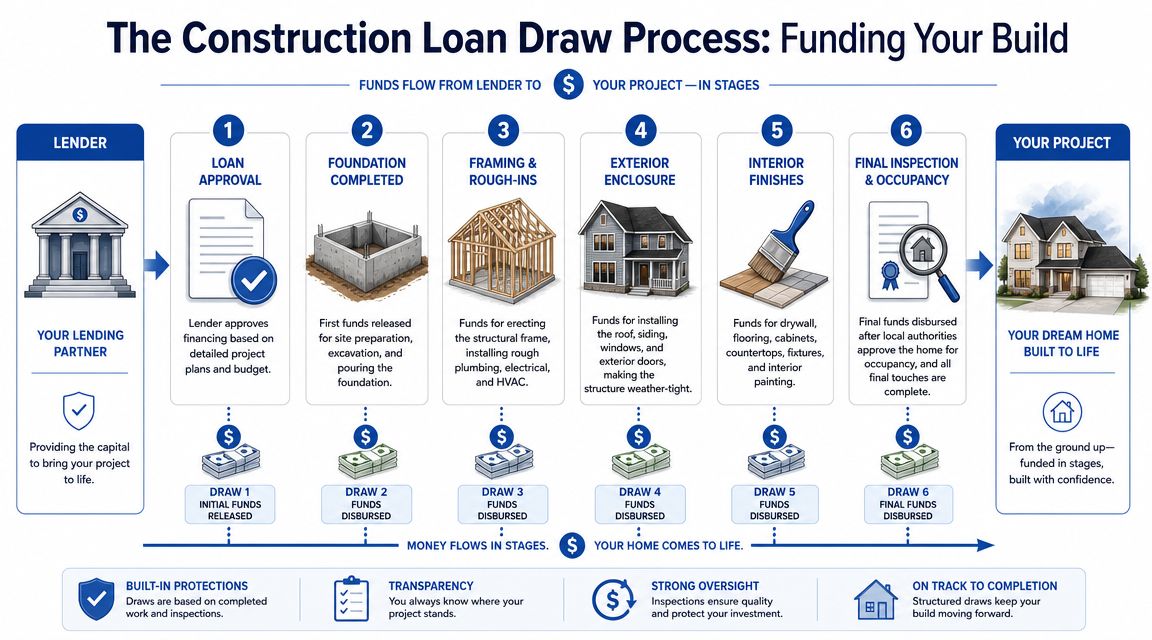

This walkthrough gives a useful visual explanation of how staged construction funding works in practice.
What keeps draws from turning into jobsite delays
The projects that hold together usually have a few simple controls in place.
- Request inspections before the phase is fully wrapped up: Waiting until the crew is finished often creates dead time while everyone waits for availability.
- Tie each draw to clear milestones: “Framing complete” means more to a lender than a vague percentage with no backup.
- Keep change orders current: If the field has moved on but the loan file has not, approvals get messy fast.
- Track vendor terms and deposit needs: Some suppliers need money before fabrication, not after installation.
- Keep owner selections ahead of the work: Cabinets, tile, lighting, and plumbing trim decisions can affect both schedule and draw timing.
Cash planning matters here too. A simple forecasting habit helps owners see when deposits, reimbursements, and lender releases will hit instead of guessing week to week. This guide on making better financial decisions with cash flow is useful if you want a clearer handle on timing, not just total cost.
For owners who want tighter coordination between schedule, lender paperwork, and field execution, this guide to residential construction project management for custom home builds explains how those pieces fit together on an active project.
Budgeting for Reality Planning for Contingency and Overruns
One of the biggest misconceptions in residential construction loans is that the approved amount equals the full cost of getting to move-in day.
It often doesn't.
The approved loan amount is a financing decision. Your total project budget is an execution reality. Those are related, but they aren't the same thing, especially when site conditions, owner selections, permit revisions, and utility work start affecting the job.
Where budgets usually get stressed
Owners often focus on the house itself and underweight everything around it. Site prep, retaining needs, drainage adjustments, permit conditions, temporary power, utility coordination, and finish changes all have a way of showing up at expensive moments.
The pressure points are usually familiar:
- Change orders: Moving walls, upgrading windows, revising cabinetry, or reworking a stair after framing has started.
- Unseen conditions: Soil issues, drainage problems, buried debris, or utility conflicts that weren't obvious at purchase.
- Selection drift: A budget built around one finish level can break quickly when every room gets upgraded.
- Schedule slippage: More time under construction means more interest carrying cost and more opportunities for labor resequencing.
A healthy contingency doesn't mean you expect failure. It means you understand construction well enough to expect unknowns.
Plan the budget in layers
Think in layers, not one big number.
| Budget Layer | What it covers |
|---|---|
| Core construction budget | The contract scope needed to build the house as designed |
| Owner equity and out-of-pocket costs | Cash contributions, upgrades, or expenses outside lender coverage |
| Contingency reserve | Funds set aside for legitimate surprises and overruns |
| Post-build finish items | The things owners often remember late, such as landscape completion or punch-related upgrades, depending on scope |

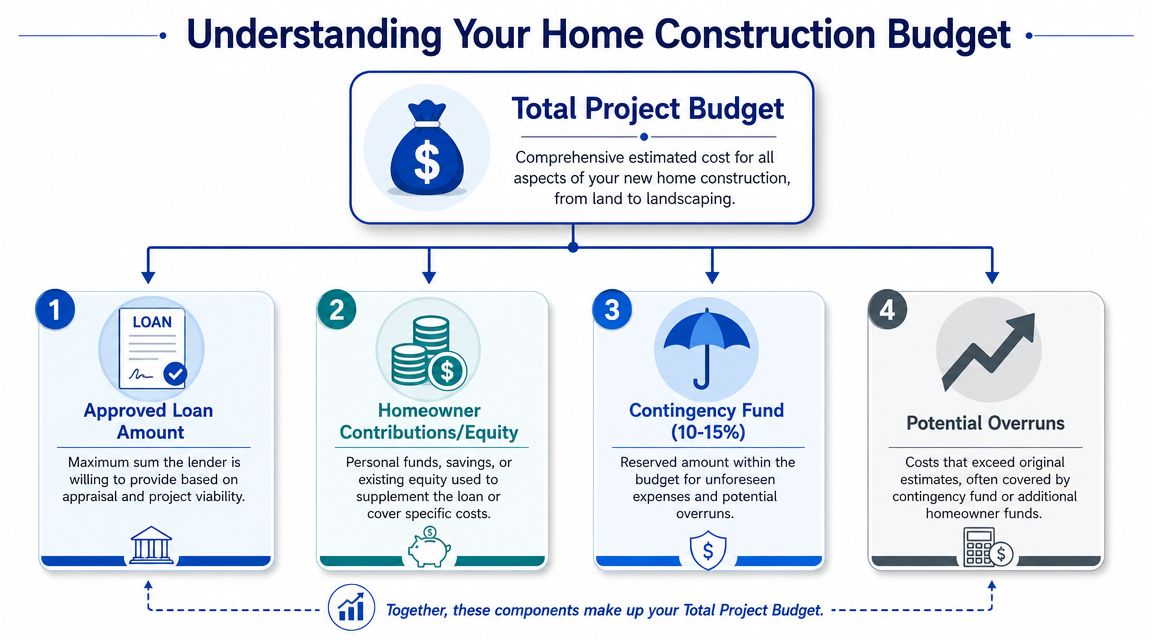

The infographic above includes a contingency fund shown at 10-15%. Treat that as the visual framework provided for budgeting discussion here, not a universal promise for every lender or project. In practice, the right buffer depends on site complexity, design certainty, and how much decision-making is still unresolved before construction starts.
Cash flow discipline matters
A detailed spreadsheet isn't glamorous, but it prevents rushed decisions. If you want a simple framework for making better financial decisions with cash flow, a structured projection template can help you see when owner cash, loan draws, and vendor obligations may stop lining up.
The builds that stay calm usually share one trait. The owners know which costs are fixed, which are allowances, and which decisions could trigger a budget change before they approve them.
Seattle-Tacoma Specifics Navigating Local Building Challenges
Building in the Puget Sound region comes with a different level of pre-construction homework than many homeowners expect.
In the Seattle-Tacoma market, financing is only part of the challenge. A project can look viable on paper and still get slowed by topography, permit comments, utility requirements, or design revisions driven by site conditions. That's one reason local experience matters so much on residential construction loans. The loan has to support a project that can move through local approval and field conditions.
The land stage is often the hardest stage
One issue many homeowners miss is the financing gap before the house starts going vertical. FDIC research found that loans tied to early development stages such as land purchase and lot development have significantly higher losses than loans for vertical construction, which helps explain why this part of the stack can be harder to finance and more heavily scrutinized (FDIC research on development-stage loan risk).
That's highly relevant in Seattle-area neighborhoods where lot acquisition, slope management, drainage, and access can define the whole project before concrete is even scheduled.
Common local friction points
Here's where Seattle-Tacoma jobs often get complicated:
- Permitting: Review timelines can stretch, and comments can require design updates that affect both scope and start date.
- Site conditions: Sloped lots, drainage issues, and soil stability concerns can change engineering and excavation strategy.
- Utility coordination: Water, sewer, storm, and power coordination can become a schedule item of its own.
- Code-driven detailing: Seismic and energy-performance expectations can shape framing, envelope, and mechanical choices.
In this region, buying the lot is not the same thing as understanding the lot.
A homeowner comparing options for ground-up work in this area should spend time with a local overview of new home construction in Washington State. It helps frame the administrative side of building here, not just the design side.
Conclusion Building Your Future with Confidence
A construction loan works best when you stop thinking of it as separate from the project. It isn't separate. It controls when funds move, how inspections affect progress, how long carrying costs stay in play, and how much room you have to absorb surprises without losing momentum.
That's why the smoothest builds usually start with better preparation, not faster borrowing. Clear plans matter. A realistic budget matters. A builder who can coordinate the schedule, paperwork, permit path, and draw process matters just as much.
Three decisions shape most outcomes:
- Choose the right loan structure: Keep the financing format aligned with your tolerance for complexity and end-loan risk.
- Build a lender-ready project file: Drawings, scope, contract terms, and budget need to tell one coherent story.
- Manage the project as tightly as the money: If selections, inspections, and documentation drift, the financing starts to drag with them.
Seattle-area projects add another layer because land conditions and local approvals can affect the build before framing even begins. That makes early planning more valuable here than in simpler markets.
The good news is that residential construction loans can work very well when the project team respects the mechanics. Staged funding, milestone inspections, and interest-only carrying periods are manageable when the builder and owner treat them as part of daily project control instead of bank paperwork off to the side.
If you're planning a custom home, major renovation, or rebuild in the Greater Seattle-Tacoma area, start the financing conversation while the plans, budget, and site strategy are still taking shape. That's when you are in the best position to avoid expensive mistakes.
Turning Point Ventures, LLC helps Seattle-area homeowners connect design, budgeting, permitting, and on-site execution into one coordinated process. If you're weighing residential construction loans for a custom build or major renovation, start with a conversation about the project itself. The clearer the scope, schedule, and site plan are at the front end, the smoother the financing tends to go. Learn more at Turning Point Ventures, LLC.
