Jack & Jill Bathroom: A Seattle Builder’s Planning Guide

June 15, 2026

You're probably looking at a floor plan that used to work fine when the kids were younger, or before one bedroom became a guest room, office, or both. Now the hallway bath is a choke point. Someone's brushing teeth, someone else needs the shower, and everybody's waiting on one door.

That's where a Jack & Jill bathroom starts making sense. Not as a Pinterest idea, and not because the name sounds clever. It works because it gives two bedrooms direct bathroom access without carving out space for two separate full baths. In Seattle-area remodels, that usually means better daily function, tighter planning, and fewer wasted square feet, but only if the layout is thought through before demolition starts.

The homeowners who are happiest with this setup usually ask practical questions early. Can two people use it at once? How much privacy will it have? What will permitting look like if we're moving plumbing or changing walls? And what happens to the budget when we open things up and find old framing, past repairs, or electrical that needs updating? Those are the right questions.

The Morning Rush Problem a Jack & Jill Bathroom Solves

Most families don't start by saying they want a Jack & Jill bathroom. They start by saying the current setup isn't working.

A common Seattle-area scenario is two adjacent bedrooms sharing a single hall bath. It functions on paper, but the traffic pattern is bad. Bedroom doors open into the hall, the bathroom door stays occupied, and the hallway turns into a waiting room every weekday morning. In older homes, that problem gets worse because the bathroom was built for one user at a time, not overlapping schedules.

A Jack & Jill bathroom addresses that bottleneck by putting the bath directly between two bedrooms. Each room gets its own entrance, so the users don't have to step into the hall and compete for access with the rest of the house. A design history overview notes that Jack and Jill bathrooms became especially popular in the 1970s, and defines the layout as a shared bathroom between two bedrooms with two direct bedroom entrances and no hallway door, a setup that aimed to preserve ensuite-style convenience while using space more efficiently in family housing (design-history overview of Jack and Jill bathrooms).

That sounds simple, but the value is in how it changes the house's daily rhythm.

Where it works best

This layout tends to solve real problems in a few situations:

  • Sibling bedrooms: Two kids share one bath, but each still has direct access from their own room.
  • Guest rooms: Visitors get semi-private access without crossing a public hall in pajamas.
  • Upper-floor remodels: When square footage is tight, sharing one well-planned bath often works better than forcing two undersized baths into the footprint.

Practical rule: A Jack & Jill bathroom should reduce friction, not just relocate it. If the new layout still creates one-user-at-a-time traffic, it hasn't solved the real problem.

What homeowners usually miss

The mistake isn't choosing the concept. The mistake is assuming any bathroom between two bedrooms will work. It won't.

If the space doesn't handle simultaneous use, secure door control, storage, and sound separation, you end up with the same conflict in a different shape. The layout can be a smart fix, but only when the plan is built around how people move through the house on a Tuesday morning.

Understanding the Core Concept and Tradeoffs

A real Jack & Jill bathroom has a clear definition. It's a shared bathroom positioned between two bedrooms, with direct entry from each room. Not a hall bath that happens to sit nearby. Not a bathroom with one bedroom door and one hallway door. The direct two-room connection is the point.

A modern double vanity bathroom with neutral wood cabinets and matching doors to two adjacent bedrooms.

The non-negotiable parts

Three features make this layout function well:

  • Two bedroom entrances: Each user gets direct access.
  • A shared bathing core: The toilet, tub, or shower area serves both rooms.
  • Independent grooming space: Many design guides recommend two sinks or separate vanity zones to cut down on bottlenecks, which is one of the defining practical advantages of the layout as it's commonly planned today.

That last point matters more than homeowners expect. If two people share one doorway and one sink area, convenience drops fast. A bathroom can technically qualify as Jack & Jill and still be annoying to live with.

Why the layout took hold

The reason this arrangement became so widely recognized in the modern era is straightforward. It answered a housing problem. Families wanted bedroom-adjacent convenience without paying for, cleaning, heating, and framing fully separate bathrooms for each bedroom.

That's why the layout became strongly associated with efficient family housing in the 1970s. It offered some of the feel of an ensuite, but in a more economical footprint than duplicating full baths.

The tradeoffs nobody should sugarcoat

There's no perfect bathroom plan. A Jack & Jill bathroom trades one set of advantages for another.

Issue What works What fails
Privacy Separate sink and bathing zones Everything opens into one room
Daily flow Two users can overlap without conflict One sink and one occupied doorway
Bedroom convenience Direct access from both rooms One room gets the better side
Guest usability Works for known users with routines Awkward if visitors don't understand door locking

The layout usually makes the most sense when the users know each other well and have recurring routines. Siblings do fine with it when the privacy setup is solid. Long-term guests can use it comfortably if the locks, door swings, and circulation are obvious. Random overflow guests tend to find it less intuitive than a hall bath.

The best Jack & Jill bathrooms feel organized, not shared. That difference comes from planning, not finishes.

The first decision to make

Before anyone starts drawing tile patterns or picking faucets, decide what problem the remodel is solving.

If you need two bedrooms to have fast, direct, semi-private access, this layout is a strong candidate. If your bigger concern is maximizing separation between users, then a true ensuite plus a hall bath may fit better. That choice drives everything that comes later, from framing changes to door hardware to how much plumbing work the house can absorb.

Smart Layouts That Maximize Privacy and Flow

Privacy is where most Jack & Jill bathrooms either succeed or fail. The attractive photos online don't tell you whether two people can use the room without conflict. That's the part that matters in real life.

A recurring concern in homeowner discussions is privacy and conflict reduction, and one practical takeaway is that the most workable versions often need three separated zones: two sink areas plus a shared tub and toilet room for siblings, guests, or teens (privacy and conflict considerations for shared layouts).

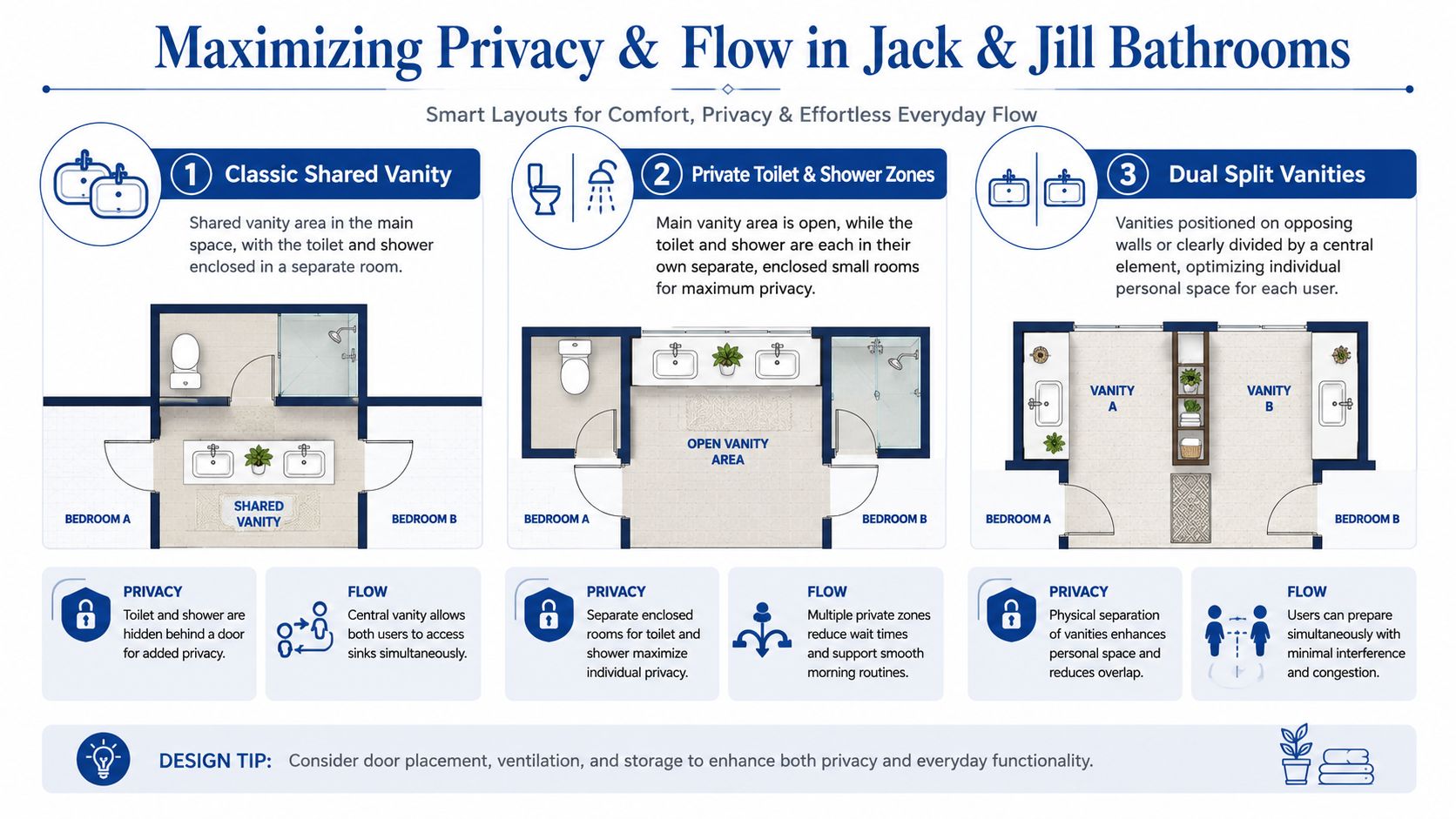

A design infographic showing three layouts for maximizing privacy and efficiency in a Jack and Jill bathroom.

The layout that works most often

For most remodels, the strongest plan is a shared vanity zone outside a separate wet room. Two users can brush teeth, wash up, or use storage while the toilet and shower stay behind a lockable interior door.

That arrangement does three things well:

  • It shortens wait times: One person doesn't control the entire bathroom just by showering.
  • It improves privacy: The most sensitive functions happen behind a second layer of separation.
  • It reduces door conflict: Bedroom doors can stay independent while the central wet zone stays controlled.

If you want a visual example of how the shower portion can be planned within a shared setup, this Jack & Jill shower layout guide is useful for thinking through enclosure options and circulation.

Three common planning models

Classic shared vanity

This is the most common and usually the best value. Both bedrooms enter a common vanity area with one long counter or a double vanity. The tub, shower, and toilet sit in a separate enclosed room beyond it.

This model works when the footprint is moderate and the users share similar schedules. It gives good daily flow without overcomplicating the build.

Split privacy plan

This version gives the toilet and shower their own separated enclosures, or at least creates more internal compartmentalization. It's excellent for older kids, guest suites, or households that care a lot about privacy.

It also adds doors, framing, ventilation planning, and finish transitions. More privacy, more complexity.

Here's a visual walkthrough that helps explain how these circulation choices affect the finished room.

Dual split vanity arrangement

This approach gives each user a more distinct grooming area, often on opposite walls or divided by a central partition. It can feel calmer and more personal, especially for teens or adults sharing the space.

The tradeoff is width. In many remodels, the existing footprint won't support this layout without taking square footage from the bedrooms or adjacent closets.

Details that make or break the room

A good plan isn't just where the vanity goes. The small technical decisions are what keep the bathroom from feeling chaotic.

  • Door swing management: Too many hinged doors can collide fast. That's often the first circulation problem I flag on plan review.
  • Sound control: If the toilet wall backs up to a bed wall, occupants will notice. Reworking wall locations can be worth it.
  • Ventilation placement: Shared baths get used hard. Moisture removal needs to be treated as a performance issue, not a fixture afterthought.
  • Storage separation: If both users dump everything into one drawer bank, daily friction comes back immediately.

Privacy in a shared bathroom comes from compartmentalization, clear locking logic, and enough personal storage. Finishes don't solve those problems.

Budgeting Your Project The Seattle-Tacoma Reality

This is the part where homeowners usually want one clean number. Real remodels don't work that way.

A mid-range Jack and Jill bathroom renovation typically costs $18,000 to $35,000, while luxury versions can exceed $50,000, according to a construction guide that also recommends planning around 50 to 75 square feet for comfortable shared use (cost and planning guide for Jack and Jill bathroom remodels). In Seattle and Tacoma, homeowners should expect the local labor market, permit handling, access constraints, and finish selections to push the conversation toward the upper part of a realistic range more often than toward the low end.

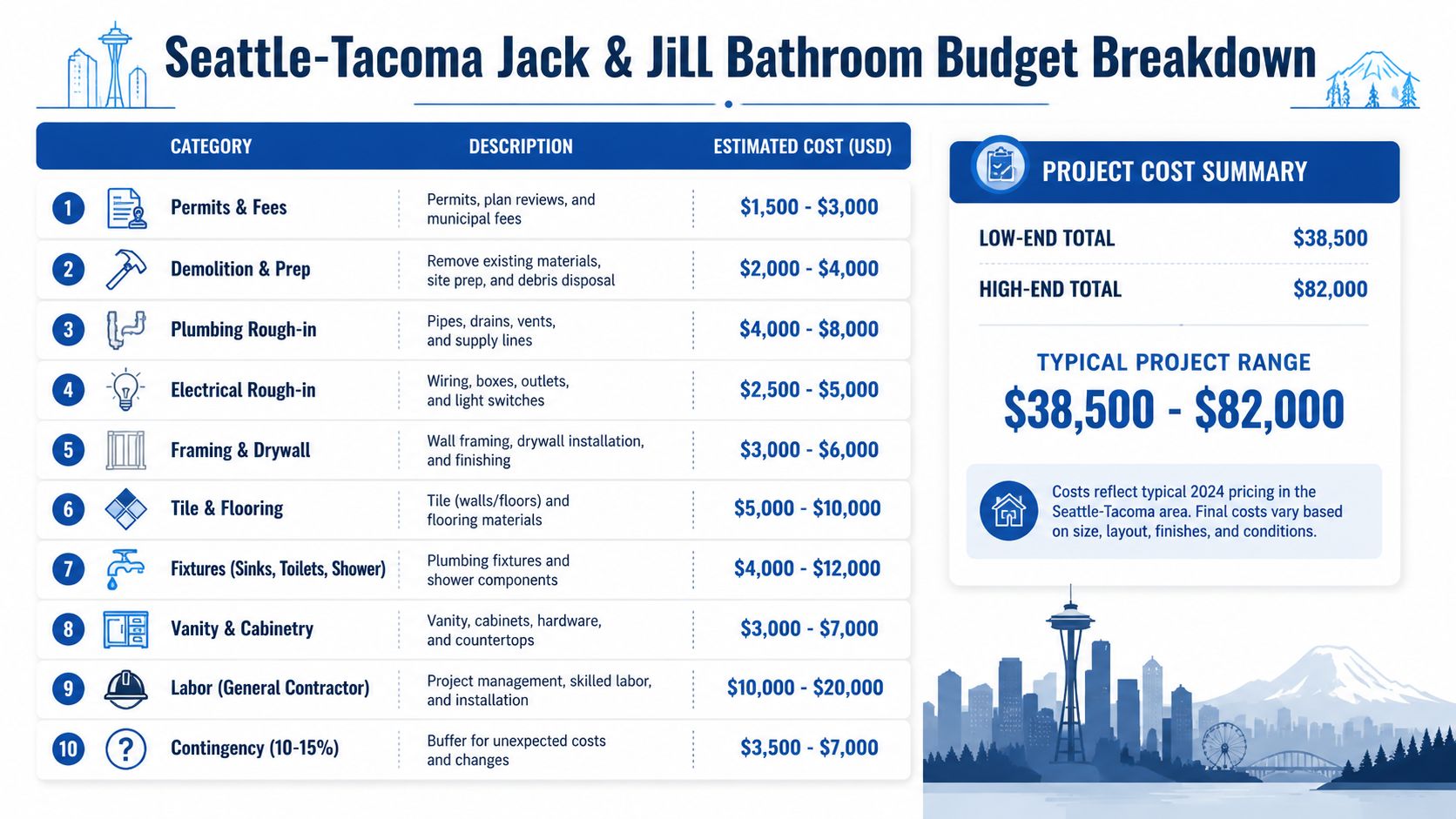

A detailed budget breakdown chart for a Jack and Jill bathroom remodel project in Seattle-Tacoma.

Where the money actually goes

That same guide breaks a $25,000 remodel into specific categories:

Cost category Budget range
Plumbing rough-in and fixtures $5,000 to $7,500
Tile and labor $4,000 to $6,500
Vanity and counters $3,000 to $5,500
Doors and hardware $1,200 to $2,500
Electrical and ventilation $1,500 to $2,500
Demo, drywall, paint, and trim $4,000 to $6,000

Those numbers are useful because they show where scope changes hit hardest. If you move supply and drain lines, plumbing costs climb. If you choose extensive tile work, custom niches, or intricate layouts, labor follows. If the plan requires more doors and better hardware because the bathroom has multiple access points, that line item matters more than people expect.

For a broader view of how bathroom costs stack up across categories, this bathroom renovation cost breakdown can help homeowners compare allowances before they start requesting bids.

The line item most people underbudget

Contingency.

The same remodeling guide advises holding 10% to 20% of the total project budget as contingency, which equals $2,500 to $5,000 on a $25,000 remodel. That isn't padding. It's what responsible planning looks like once walls come open.

Budget reality: The expensive part of a remodel usually isn't the thing you picked. It's the condition you uncover.

In Seattle-area homes, especially older ones, hidden conditions are common. You may find previous plumbing patches, framing that needs correction, old exhaust routing, damaged subfloor, or electrical work that no longer supports the new layout cleanly.

What homeowners can control

You can't control every unknown, but you can control several major budget drivers:

  • Keep plumbing close to existing locations: Reuse the current wet wall where possible.
  • Choose one or two finish priorities: Spend on the vanity, or the tile, or the shower glass. Don't make every surface the hero.
  • Simplify the door strategy: More doors and more specialty hardware usually mean more coordination and more cost.
  • Order materials early: Delays often create labor inefficiency and resequencing.

If you're interviewing contractors, ask for an allowance-based estimate that clearly separates fixed scope from owner-selected finishes. That's how you compare bids without getting fooled by missing items.

Navigating Timelines Permits and Project Management

Most bathroom remodel stress comes from uncertainty, not tile. Homeowners can handle disruption when they know what's happening, who's responsible, and what decisions are due next. Problems start when the project moves forward before scope, selections, and permit triggers are resolved.

The process gets more involved if you're moving walls, reworking plumbing, changing electrical, or altering ventilation. A Jack & Jill bathroom often touches several of those at once because you're not just refreshing surfaces. You're changing how two bedrooms and one bathroom connect.

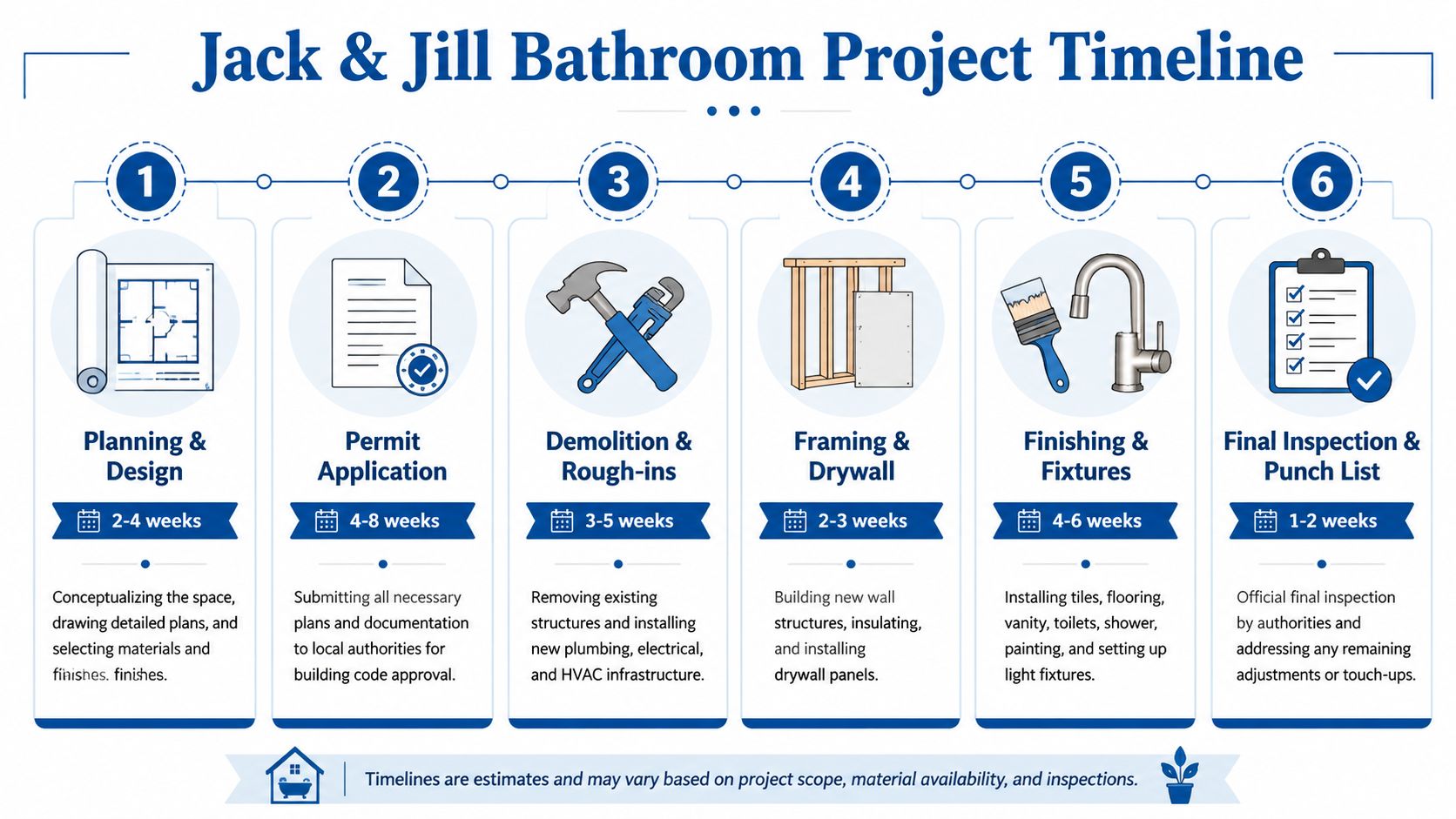

A six-step infographic detailing the timeline for a Jack and Jill bathroom renovation project.

The practical sequence

Here's the project flow I'd want any homeowner to understand before work begins:

  1. Planning and layout
    Decide which walls stay, which fixtures move, and how the doors will function. Most preventable mistakes are identified at this point.

  2. Selections and scope lock
    Pick plumbing fixtures, tile, vanity approach, lighting, hardware, and ventilation direction before permits are submitted if those choices affect the plans.

  3. Permit review
    If the remodel changes structural framing, plumbing, electrical, or mechanical systems, permit review is usually part of the path. That review doesn't move at the pace of homeowner enthusiasm.

  4. Demolition and rough-in
    Once the room opens up, the old house tells the truth. This phase often confirms whether the original plan still holds cleanly.

  5. Close-in and finish
    Inspections, drywall, waterproofing, tile, trim, cabinetry, fixtures, and punch list all happen here. This stage looks visually satisfying, but it only runs well if the rough work was organized.

For homeowners who want a broader remodel roadmap before they hire anyone, this bathroom planning guide for renovations is a good preconstruction checklist.

Permits in the Seattle-area context

Permits matter because bathrooms involve systems, not just finishes. If you're replacing like-for-like surfaces in the same configuration, the process is simpler. If you're creating new door openings, changing plumbing routes, adding lighting, relocating fans, or touching structure, permit requirements become much more likely.

What slows projects down isn't just the permit itself. It's incomplete drawings, late material decisions, and revisions after submission. Homeowners often lose more time to indecision than to construction.

Start permit drawings only after the layout logic is settled. Revising the doorway plan or fixture arrangement midstream wastes time twice.

What good project management looks like

A smooth job usually has these traits:

  • One decision log: Everyone knows what was selected, what's still pending, and what deadline matters.
  • A procurement plan: Long-lead fixtures, glass, tile, and vanities are tracked before demolition.
  • Inspection awareness: Rough inspections shape the schedule whether homeowners think about them or not.
  • Site protection and access planning: In occupied homes, dust control and daily cleanup aren't extras. They're basic management.

This is also where working with a contractor that handles coordination matters. Firms such as Turning Point Ventures, LLC offer project-managed residential remodeling in Washington, including bathrooms, which is relevant when a Jack & Jill layout requires permit handling, trades scheduling, and finish coordination across multiple rooms.

How to prepare your household

Before work starts, do three things:

  • Set a temporary bathroom plan: Don't figure this out on demo day.
  • Clear adjacent bedrooms fully: These projects affect both rooms, not just the bath.
  • Make finish decisions early: Waiting on mirrors, hardware, or specialty fixtures can stall close-out.

A remodel goes better when the homeowner treats preconstruction as part of construction. It is.

Is It a Smart Long-Term Investment for Your Home

The right answer depends less on style than on who will use the bathroom over the next several years.

One of the most important under-answered questions is whether a Jack & Jill bathroom remains a good long-term value as households place more weight on privacy, guest comfort, and flexible daily routines. A useful way to judge it is by comparing it against a true ensuite plus a hall bath, using privacy, maintenance, and family workflow as the decision criteria rather than aesthetics alone (long-term value discussion around Jack and Jill layouts).

When it's a strong investment

A Jack & Jill bathroom usually makes sense when:

  • Two adjacent bedrooms have similar status: sibling rooms, guest rooms, or secondary bedrooms.
  • You want efficient use of space: especially when adding two separate bathrooms would overbuild the floor plan.
  • The household values access more than separation: direct bedroom entry has real day-to-day value.
  • Cleaning one shared bath is preferable to maintaining two smaller baths: fewer waterproofed areas often means simpler upkeep.

For many family homes, that's a practical long-game decision. You improve function without committing square footage and budget to duplicated rooms that may not get equal use.

When I'd push a homeowner to consider another plan

There are also cases where I'd seriously compare alternatives.

If one bedroom is clearly a future primary guest suite, or if one occupant needs much more privacy than the other, a split arrangement may hold up better over time. The same goes for households thinking about aging in place, frequent visitors, or multi-generational living. In those homes, shared access can feel efficient at first and restrictive later.

Here's a simple comparison:

Option Better for Watch out for
Jack & Jill bathroom Siblings, guest rooms, efficient upper-floor plans Privacy conflicts if compartmentalization is weak
Ensuite plus hall bath Mixed user types, guests, aging-in-place flexibility More square footage, more cost, more maintenance

Think past the bathroom itself

This decision also affects surrounding finishes and long-term upkeep. Flooring, for example, matters more in a shared bathroom because the room sees heavier daily use from multiple users. Homeowners weighing finish durability alongside resale and maintenance may find this guide to smart flooring investments helpful when choosing materials that fit a forever-home mindset instead of just a showroom look.

The best investment choice is usually the one that matches the house's actual bedroom hierarchy. If the two bedrooms are true peers, a Jack & Jill bathroom often feels intentional. If they aren't, the arrangement can feel like a compromise buyers notice.

The final test is simple. Ask whether the layout will still make sense if schedules change, kids get older, guests stay longer, or one room shifts to office use. If the answer is yes, the project has long-term logic. If the answer is maybe, spend more time on the floor plan before spending money on the build.


If you're planning a Jack & Jill bathroom in the Greater Seattle-Tacoma area and want help with layout, permitting, budgeting, or full project coordination, Turning Point Ventures, LLC is a Washington-based option for custom remodeling work. A good first step is a planning conversation that clarifies scope, identifies likely permit triggers, and puts real numbers around the build before selections and demolition begin.
