Most Seattle kitchen remodels in 2026 fall in the $130,000 to $250,000+ range, with mid-range projects commonly landing between $160,000 and $200,000. If you're planning around national averages, you're probably starting from the wrong number for this market.
That gap matters because Seattle remodel pricing isn't just about prettier cabinets or a bigger island. It's driven by scope, permitting, older housing stock, layout changes, coordination between trades, and the simple fact that a kitchen is one of the densest rooms in a house from a construction standpoint. A kitchen can look straightforward on Pinterest and still become a complex build once walls open up, electrical is exposed, and the city requires reviewed work.
A realistic discussion of kitchen remodel cost in Seattle has to cover the whole job. That means design, sequencing, procurement, inspections, and the decisions that push a project from manageable to expensive.

Deconstructing Seattle Kitchen Remodel Costs
A Seattle kitchen can span a very wide range before you even pick the cabinet style. Emerald City Build's Seattle kitchen cost guide places many 2026 projects between $130,000 and $250,000+, with mid-range remodels at $160,000 to $200,000 and high-end work starting around $225,000. The same source estimates roughly $700 to $1,200 per square foot, which puts a 150-square-foot kitchen around $105,000 to $180,000 and a 250-square-foot kitchen around $175,000 to $300,000.
Those numbers are useful, but the better question is what kind of job you are building.
A kitchen remodel usually falls into one of three buckets: a basic update with the layout intact, a full replacement with better materials and more trade coordination, or a custom rebuild that changes how the room works. The bucket matters because cost follows scope, approvals, scheduling complexity, and the amount of problem-solving required once demolition starts.
| Project tier | What it usually means | Typical Seattle range |
|---|---|---|
| Basic update | Limited changes, existing layout largely preserved, fewer mechanical revisions | $50,000 to $90,000, based on local Seattle remodel pricing published by CRD Design Build |
| Full replacement | Pull-and-replace work, stronger finish package, moderate design and installation coordination | Earlier Seattle benchmarks place many of these projects in the $100,000 to $200,000 range, depending on material level and whether utilities stay put |
| Custom reconfiguration | Major layout changes, custom cabinetry, structural work, utility relocation, more review and management | Earlier Seattle benchmarks place these projects in the $150,000 to $250,000+ range, with upper-end work rising further when scope expands |
That distinction saves homeowners from one of the most common budgeting mistakes I see. They describe the job as a mid-range remodel, but the actual scope includes moving plumbing, widening openings, adding windows, upgrading electrical, and ordering fully custom cabinets. That is a custom project from a planning and cost standpoint, even if the finish selections are restrained.
Square footage helps, but scope drives the job
Per-square-foot pricing is a starting tool. It is not how a contractor manages risk.
Two kitchens with the same footprint can land far apart in price. A smaller room that needs a panel upgrade, revised plumbing, ductwork changes, asbestos testing, and custom fillers can cost more than a larger kitchen where the layout stays intact and the field conditions are clean. In practice, the biggest cost swings come from what has to be coordinated behind the finishes and how many decisions need to be locked before production starts.
That is why rough calculators are only rough calculators. If you want an early planning number before meeting with a contractor, this Seattle kitchen remodel cost calculator can help frame the conversation. After that, the primary work is defining scope clearly enough that allowances, permit needs, lead times, and site conditions are accounted for before the budget gets tested in the field.
Financing also shapes the project strategy. Buyers taking on older properties with heavy deferred maintenance sometimes review options such as fixer up home loans for investors when the kitchen work is part of a larger renovation plan from day one.
Why Seattle Kitchens Cost What They Do
In Seattle, the same kitchen footprint can produce very different bids. The reason is scope management, not just finish selection.
A kitchen budget rises fastest when the project changes systems instead of surfaces. New cabinet fronts and counters are straightforward to price. Moving plumbing, revising electrical, upgrading ventilation, opening a wall, or correcting older conditions creates a chain of work across several trades, and every handoff has to be coordinated.
The expensive part is coordination
I tell clients this early. A kitchen is a scheduling job before it is a finish job.
If the sink moves, that change can affect plumbing rough-in, cabinet layout, countertop templating, flooring repair, inspection sequencing, and sometimes appliance clearances. If the range moves, the conversation may expand to gas, electric, venting, and make-up air requirements. If a wall comes out, the work may include engineering, framing changes, patching adjacent finishes, and updates to lighting or HVAC runs that were hidden in that cavity.
That is why two remodels with similar material selections can end up far apart on price.
The biggest cost drivers usually look like this:
- Layout changes: Relocating the sink, range, refrigerator, or island adds labor across multiple trades.
- Structural revisions: Removing or altering walls increases design review, permit scrutiny, and field complexity.
- Older home corrections: Demolition often exposes wiring, plumbing, framing, or moisture issues that need to be addressed before finishes go back in.
- Mechanical and electrical upgrades: Service capacity, vent routing, and code-required protections can add work that was never visible during the first walkthrough.
Pull-and-replace versus reconfiguration
A pull-and-replace kitchen is still a real remodel. Cabinets have to be measured correctly, appliances have to fit, lighting needs a plan, and lead times have to be managed. But the layout staying put reduces the number of unknowns, which makes the budget easier to control.
A reconfiguration has more decision points and more chances for delay if details are not resolved before work starts. That is the part homeowners often miss. The price increase is not only about extra materials. It comes from design hours, permit documentation, trade sequencing, inspections, and the risk of discovering conflicts once walls and floors are open.
For that reason, layout changes should earn their keep. A better working triangle, more aisle clearance, improved storage, or cleaner circulation can justify the added cost. Swapping positions just because it looks simple on paper usually does not.
If you want a clearer sense of how scheduling ties directly to labor cost, permit timing, and trade overlap, this guide on how long a kitchen remodel takes in Seattle helps frame the essential planning work behind the number.
Homeowners often focus on quartz versus marble and miss the larger budget question. Significant costs usually arise when the project changes infrastructure.

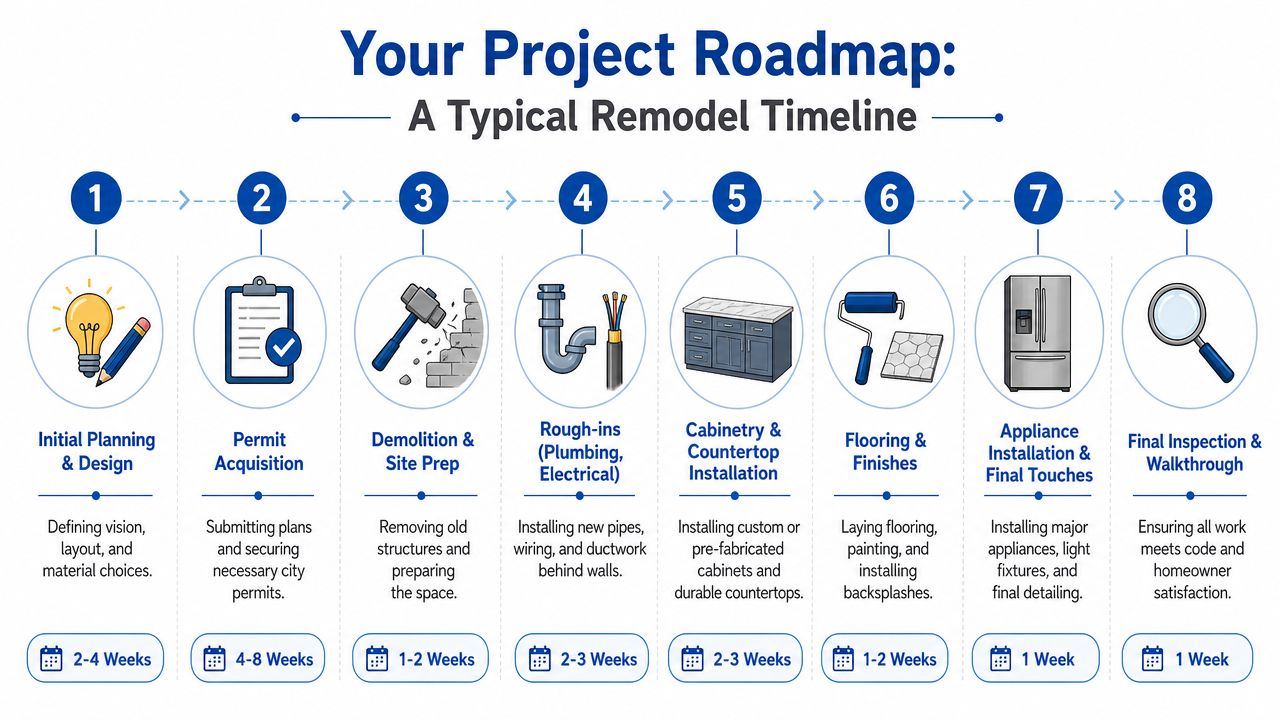

Your Project Roadmap A Typical Remodel Timeline
Most budget stress in a kitchen remodel comes from uncertainty. The timeline feels vague, so the costs feel vague too. A well-run project doesn't remove every variable, but it does give each phase a purpose and a sequence.
A major Seattle kitchen remodel often lands in the broad range many homeowners describe as several months, not several weeks. The reason is simple: design decisions, permit review, material procurement, inspections, and field coordination all have to line up. If one piece slips, the next trade can't always start on time.
To make the process easier to visualize, here's the full roadmap:
Phase by phase
Initial planning and design
Scope is defined during this phase. Not just style. Actual scope. Appliance sizes, cabinet strategy, traffic flow, lighting plan, storage needs, and whether the layout stays or changes.Permit acquisition and procurement
This phase is where many homeowners think "nothing is happening," but a lot is happening. Plans are refined, materials are ordered, and permit packages move through review.Demolition and site prep
Demo is fast. Protecting the rest of the house, staging debris, managing dust, and keeping the site safe take discipline.Rough-in work
Plumbing, electrical, and ventilation go in before walls close. This stage determines whether the kitchen will function well, not just look good.
A separate breakdown of sequencing is helpful if you want a more detailed planning reference. This kitchen remodel timeline guide for homeowners gives a practical view of what usually happens and when.
Where timelines actually slip
The biggest delays usually aren't dramatic. They're small planning failures that stack up.
- Late selections: If fixtures, appliances, or cabinet details aren't finalized early, field crews stall.
- Scope drift: Mid-project changes affect drawings, purchase orders, and installation sequence.
- Inspection timing: Rough inspections and finals need to happen in the right order.
- Lead-time surprises: A missing panel or delayed faucet can hold up multiple follow-on tasks.
This short video gives a useful visual overview of the remodeling process and why sequencing matters:
A kitchen remodel stays on schedule when decisions are made before crews need them, not when the homeowner is standing in the half-demolished room.
What good project management looks like
Good management isn't flashy. It shows up in clean scopes, organized selections, realistic procurement plans, and daily coordination between trades. Homeowners feel the difference when the electrician isn't waiting on a cabinet answer and the countertop fabricator has accurate field dimensions the first time.
Navigating Seattle Permits and Hidden Costs
Many homeowners build their budget around visible items. Cabinets. Counters. Appliances. Tile. That's understandable, but it's incomplete.
A more realistic Seattle budget includes the less visible line items that make the work legal, buildable, and predictable. According to this Seattle-area remodel cost cheat sheet from UrbnLivn, soft costs such as design fees, engineering, and permitting can add 15% to 30% to remodel costs. That's the part a lot of online articles skip.
What counts as soft cost
Soft costs aren't fluff. They're the pre-construction and administrative work that lets the project move without chaos.
- Design work: Plans, elevations, layout development, and selection coordination
- Engineering: Needed when structural changes or specific conditions require formal review
- Permitting: City submissions, revisions, approvals, and inspection coordination
- Temporary setup: Keeping the household functional during a kitchen outage
- Change management: Revising scope when site conditions or homeowner decisions shift
If you only compare bids on cabinet and labor totals, you're not comparing the whole job.
Permits aren't optional overhead
In Seattle, permits become part of the project once you start changing systems or structure. Electrical changes, plumbing changes, mechanical work, and wall modifications usually bring permit and inspection requirements into play. Homeowners sometimes ask whether skipping that step saves money. It usually doesn't. It just moves risk downstream.
Unpermitted work creates problems when inspectors get involved later, when work has to be reopened, or when the house is sold and the paper trail doesn't match the finished condition. That's an expensive place to discover a shortcut.
On the job: The cheapest permit is the one you pull before construction starts. The expensive permit problem is the one discovered after finishes are installed.
Hidden costs usually come from hidden conditions
The most frustrating budget changes often come from things nobody can fully see before demolition. Once walls open, crews may find wiring that needs updating, framing that needs correction, or mechanical work that doesn't meet current expectations for the new design.
That doesn't mean every kitchen becomes a runaway project. It means the budget needs room for reality. Homeowners who plan for visible finishes only tend to feel ambushed. Homeowners who budget for the full lifecycle of the remodel are usually much calmer when the project hits normal field conditions.
How to Build a Realistic Remodel Budget
Kitchen budgets in Seattle can swing by tens of thousands of dollars based on two decisions made before demolition starts: whether you keep the layout, and how much behind-the-wall work the plan triggers. That is why a usable budget starts with scope definition and project sequence, not a mood board.
Start by naming the project accurately. Is it a cosmetic update with existing cabinet locations and limited system changes? A pull-and-replace with new finishes and fixtures in roughly the same footprint? Or a full reconfiguration that shifts plumbing, electrical, ventilation, and maybe walls? Each path carries a different level of design time, permit review, field coordination, and schedule risk. Build the budget around the work required to execute that scope cleanly.
Build a budget in layers
A single top-line allowance causes problems fast. It hides where the pressure points are, and it makes trade-offs harder once selections and bids come in. I recommend splitting the budget into planning, infrastructure, finish materials, labor, and contingency so you can see what is driving cost before the contract is signed.
Here is a practical framework for a Sample Seattle Kitchen Remodel Budget Breakdown (Mid-Range $180,000 Project):
| Category | Percentage of Budget | Sample Cost |
|---|---|---|
| Design and planning | 10% | $18,000 |
| Permits and engineering | 8% | $14,400 |
| Cabinetry and storage | 28% | $50,400 |
| Countertops and backsplash | 12% | $21,600 |
| Appliances and fixtures | 12% | $21,600 |
| Labor and installation | 22% | $39,600 |
| Flooring, paint, and finish work | 5% | $9,000 |
| Contingency | 3% | $5,400 |
Use this as a working model, not a formula. Older Seattle homes often need more budget in electrical, plumbing, patching, and correction work. Newer condos and townhomes may put more pressure on logistics, building rules, delivery coordination, and finish protection. The point is to budget for the full job lifecycle, not just the visible materials.
Put your money where the project gets easier to live with
Homeowners rarely regret spending on function. They do regret discovering late in the process that the appliance package needs a panel upgrade, the hood needs a different duct path, or the island overhang they wanted now affects circulation and cabinet sizing.
Three decisions usually protect the budget:
- Keep the footprint if the kitchen already functions well: Moving sinks, ranges, or walls tends to add design time, permit review, and field coordination.
- Choose appliances before final cabinet drawings: Appliance specs affect openings, electrical requirements, ventilation, and lead times.
- Spend on storage, lighting, and ventilation before decorative upgrades: Those items change how the kitchen performs every day.
Contingency deserves its own line item. In practice, that reserve is less about panic and more about control. It gives the project room to handle normal field discoveries without forcing rushed decisions on finishes or scope cuts.
Match the budget to the payment plan
The construction budget and the financing plan need to work together. If a refinance, renovation loan, HELOC, or future home purchase is part of the bigger picture, review the monthly payment impact before approving the final scope. A straightforward guide to debt to income ratio mortgage qualification can help frame that side of the decision.
It also helps to ask contractors how their payment schedule is tied to milestones. Deposit, rough-in completion, cabinetry delivery, countertop template, substantial completion. Clear billing stages make it easier to plan cash flow and spot gaps between selection deadlines and payment dates.
Budget for management, not just materials
Good budgeting is project management in spreadsheet form. It should reflect design decisions, permit path, lead times, temporary kitchen needs, inspection timing, and the amount of uncertainty in the house itself. That is why two kitchens with similar finishes can land at very different totals.
If you are still sorting out how to compare proposals, this guide on how to hire a general contractor for a remodel will help you evaluate scope, allowances, and communication before you commit.
For homeowners who want a structured, project-managed path from design through build, Turning Point Ventures, LLC is one local design-build option to consider alongside other qualified Seattle-area contractors.
Taking the Next Step An Accurate Local Estimate
The next smart step usually isn't collecting three fast quotes. It's defining the project well enough that the quotes mean something.
Seattle pricing changes sharply based on whether the project keeps the existing layout or reworks it. Palmer Residential's Seattle remodeling cost guidance notes that unchanged-layout projects can fall around $50,000 to $100,000+, re-envisioned kitchens begin at $100,000+, and structural changes start at $200,000+. That spread is why vague bidding produces confusing numbers. Two contractors may be pricing entirely different versions of the same kitchen.
Show up to the consultation prepared
Before you meet with a contractor, have these decisions sketched out:
- Your scope boundary: Are you preserving the footprint or changing it?
- Your all-in budget: Include design, permits, and the unknowns that come with demolition.
- Your priorities: Storage, better workflow, more light, family seating, better appliance placement, or improved resale presentation
- Your tolerance for disruption: Some families can live through a long build. Others need tighter staging and temporary kitchen planning.
Bring inspiration images if you want, but don't stop there. Bring real preferences. Full-height backsplash or not. Drawer-heavy base cabinets or doors. Gas or induction. Paneled refrigerator or freestanding. Those choices affect planning and procurement.
Choose process, not just price
The lowest number on paper often comes from missing scope, thin allowances, or weak pre-construction planning. That shows up later as change orders, schedule stress, and finger-pointing between trades.
A better consultation produces a clearer scope, a more realistic budget range, and a better forecast for permits, sequencing, and material decisions. If you're vetting builders, this guide on how to hire a general contractor is a useful filter for the questions that matter.
A good estimate doesn't just tell you what the kitchen costs. It tells you what has to happen to get the kitchen built properly.
When homeowners understand that, the conversation changes. It stops being about who can throw out the lowest number and starts being about who can manage the project without surprises.
If you're planning a Seattle-area kitchen remodel and want a process-driven conversation about scope, permitting, budget, and sequencing, Turning Point Ventures, LLC is a Washington contractor worth contacting for a consultation. The goal should be a clear plan, a realistic all-in budget, and a remodel that works on paper before construction starts.
